Free templates

Free civil site diary template

A daily site diary and earthworks record built for Australian civil projects, in CSV and printable PDF, with a companion plant and labour sheet. Free download, no signup, no email required.

Downloads

Take the files, no strings

Built around the way an earthworks day actually runs: weather, crews, plant hours, chainages, lots, tests, delays and instructions.

Daily site diary template

CSV, 31 columns

One row per day covering weather and rainfall, shift times, personnel and subcontractors, plant hours, work areas by chainage and offset, lots opened and conformed, tests, hold points, delays, instructions, safety and environmental notes. Two worked example days are included for you to overwrite.

Download

Plant and labour daily record

CSV, 14 columns

A companion sheet for machine-by-machine hours: fleet ID, owner or hire company, operator, start and finish hours, working, idle and breakdown time, work area, task and docket reference so hired-plant claims reconcile with the diary.

Download

Printable diary sheet

PDF, 3 pages

A how-to-use page, a full-page A4 landscape daily diary form ready to print for the site folder, and a blank plant and labour record for the same date.

Download

These templates are a general starting point. They are not a substitute for your contract requirements, approved project quality plan or your organisation's record-keeping obligations, so check the fields against your contract before you roll them out.

Filling it in

What belongs in each field

A diary is only worth what it records. These are the entries that get read again months later, usually by someone assessing a claim.

Date, shift times and weather

Record weather morning and afternoon, rainfall in millimetres and the state of the ground. Weather is the single most disputed field in any extension-of-time claim, and it costs ten seconds a day to get right.

Personnel and subcontractors

Names, roles and hours for your own crew, plus which subcontractors were on site and with how many people. Numbers alone are useless when you later need to prove who was standing.

Plant and equipment

Type, fleet or hire ID and hours for each machine. Separate working hours from idle and breakdown time; that split is what turns a diary into a standby claim.

Work areas and work performed

Chainage from and to plus offsets, then a plain description of what was done. Locations, not just activities, so the diary can be matched back to lots and surveys.

Lots opened and conformed

Which lots were opened, which were closed out and which tests were called. Keeping this in the diary means your daily record and your lot register never drift apart.

Hold and witness points

Who was notified, when they attended and whether the point was released. Note the time; a missed witness point is normally about notice, not about the work.

Delays and lost time

Cause, start and finish time, resources standing and the party responsible. Vague entries like "rain, lost time" are worth close to nothing months later.

Instructions, variations and directions

Every verbal or written instruction, who gave it and the reference number. If it was verbal, say so and note that you confirmed it in writing.

Safety and environmental

Toolbox topics, inductions, incidents and near misses, plus sediment control checks, dust, noise and any discharge. Regulators ask for contemporaneous records, not reconstructions.

Deliveries, visitors and sign-off

Materials received with source and quantity, who visited site, then the name, position and date of the person who wrote the entry. An unsigned diary is a weak record.

Good habits

Three rules that keep a diary useful

Most diaries fail for the same three reasons, and none of them are about the template.

Write it before you leave site

A diary written the next morning loses times, names and the exact wording of an instruction. Fifteen minutes at the end of shift is the whole discipline.

Facts, quantities and references

Times, chainages, tonnages, test numbers, instruction references. Opinions about who was at fault do not help you and can hurt you.

Never backdate or overwrite

If something was missed, add it as a later dated entry that says when it was recorded. A diary that has clearly been edited stops being evidence.

Worked example

One day, written properly

The same shift, recorded the way the template intends.

1

Conditions

Monday 2 March. Fine 14C in the morning, fine 24C in the afternoon, no rainfall, surface dry and trafficable. Shift 06:30 to 16:30.

2

Resources

Site engineer and foreman for 10 hours each, six operators from the earthworks subcontractor, D6 dozer DZ-02 for 8.5 working hours and 0.5 idle, 30 t excavator EX-11 hired under HIRE-8871 for 9 hours.

3

Work and lots

Subgrade trim and compaction CH 1,200 to 1,400, 0 to 8 m LHS. Lot SG-001 opened over 1,600 m². Topsoil lot TS-004 conformed. 420 t of select fill imported from Northern Quarry.

4

Tests and hold points

Three field density tests called, report DEN-1042, all pass. Proof roll witnessed by the superintendent's representative at 14:10 and released. Conformance survey issued for the same extent.

5

Everything else

Instruction SI-018 received clarifying trim tolerance. Toolbox on exclusion zones, one visitor inducted. Sediment fence inspected, no discharge. Nil delays. Signed by J. Smith, site engineer, same day.

Beyond the spreadsheet

Where the diary and the quality records stop agreeing

The diary says a lot was opened at chainage 1,200. Nothing in the spreadsheet proves it, or shows you what is still open along the corridor.

Two records, one truth

The diary and the lot register are maintained by different people at different times, so lot numbers, dates and extents drift apart until someone reconciles them at handover.

No picture of the corridor

A chainage typed into a cell cannot tell you which stretch is trimmed, which is tested and which is still open. That only becomes visible on the alignment.

Evidence assembled late

Pulling a claim or handover pack together from months of separate sheets is where days disappear, and where gaps in the record are discovered far too late.

Keep the diary as your daily narrative, and let ForgeLot hold the lot side of the record on your DXF alignment: lots created by chainage and offset, areas calculated for you, ITP status on the geometry, and CSV or PDF exports for the superintendent.

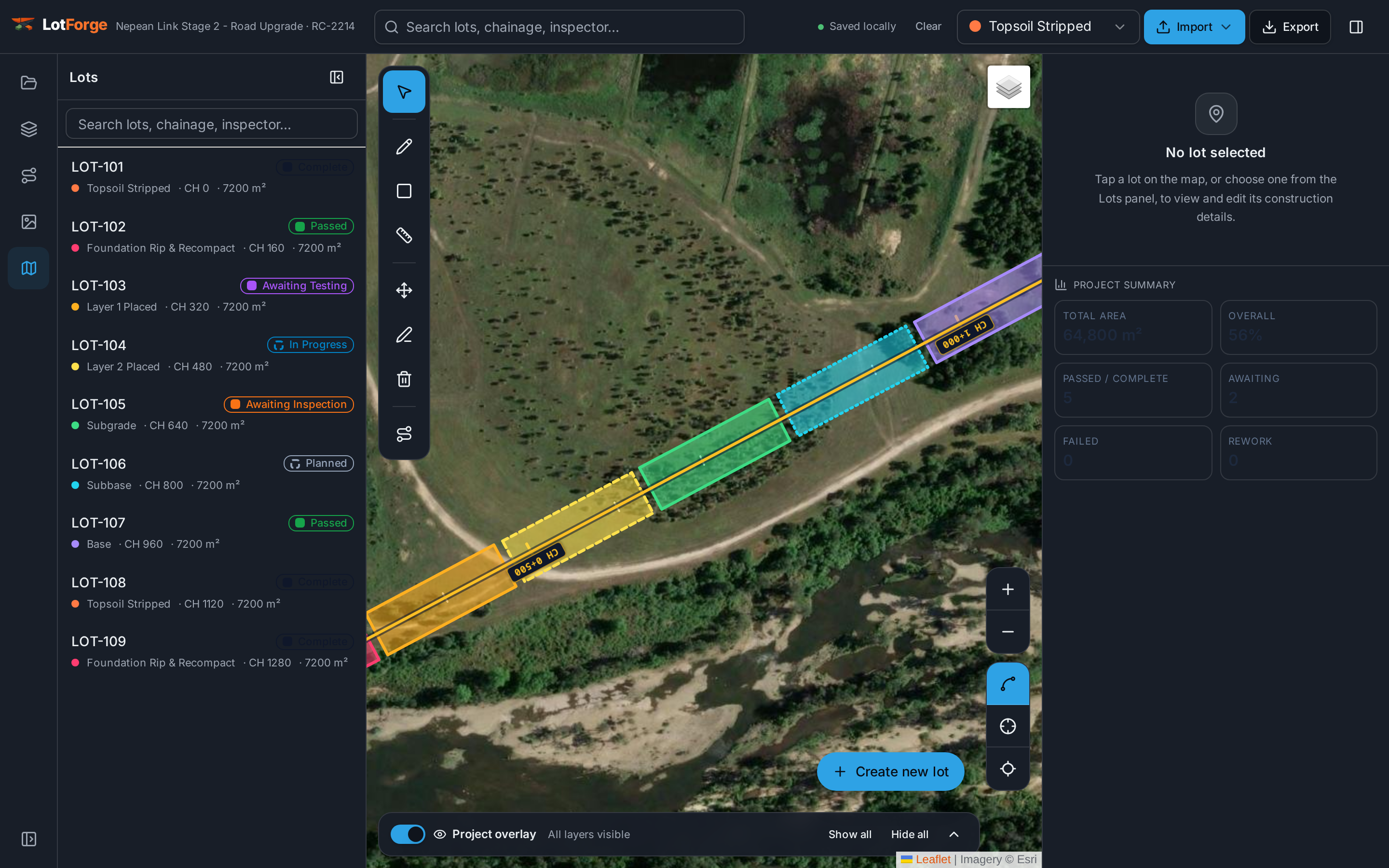

ForgeLot lot panel listing lots with chainage, construction layer and inspection status
